Portfolio and Technical Administration
Home · Reports, AI Log and Traceability · Maintenance, Support and FAQ

Objective
This page covers two distinct areas of the product:
- the Portfolio or Portfolio command center page, used to compare multiple projects;
- Platform Administration, used to prepare integrations, AI providers, subscriptions and audit.
For a beginner user, it is useful to remember:
- the Portfolio page helps answer the question “Which projects deserve my priority attention?”;
- Platform Administration helps answer the question “Is the platform properly prepared for the organization?”.
Who this page is mainly for
In the observed application, Portfolio is primarily a cross-project PMO-style review surface. It helps compare several projects with the same signal model before opening a detailed project view.
Use it mainly to:
- prioritize which project needs attention first;
- compare consistent signals across several projects;
- decide which project deserves a deeper drill-down next.
Do not treat it as a sponsor-only summary page or as a replacement for the detailed Workspace of one project.
Part 1 — Understanding the Portfolio page step by step
What is the Portfolio page for?
The Portfolio page is used to compare several projects with configurable signals instead of a simple fixed red / orange / green table.
It allows, in particular:
- selecting multiple projects;
- choosing the signals to compare;
- setting a weight and a threshold for each signal;
- filtering the minimum severity;
- saving a reusable cohort;
- spotting outliers or anomalous values;
- then opening a project’s details to understand why it stands out.

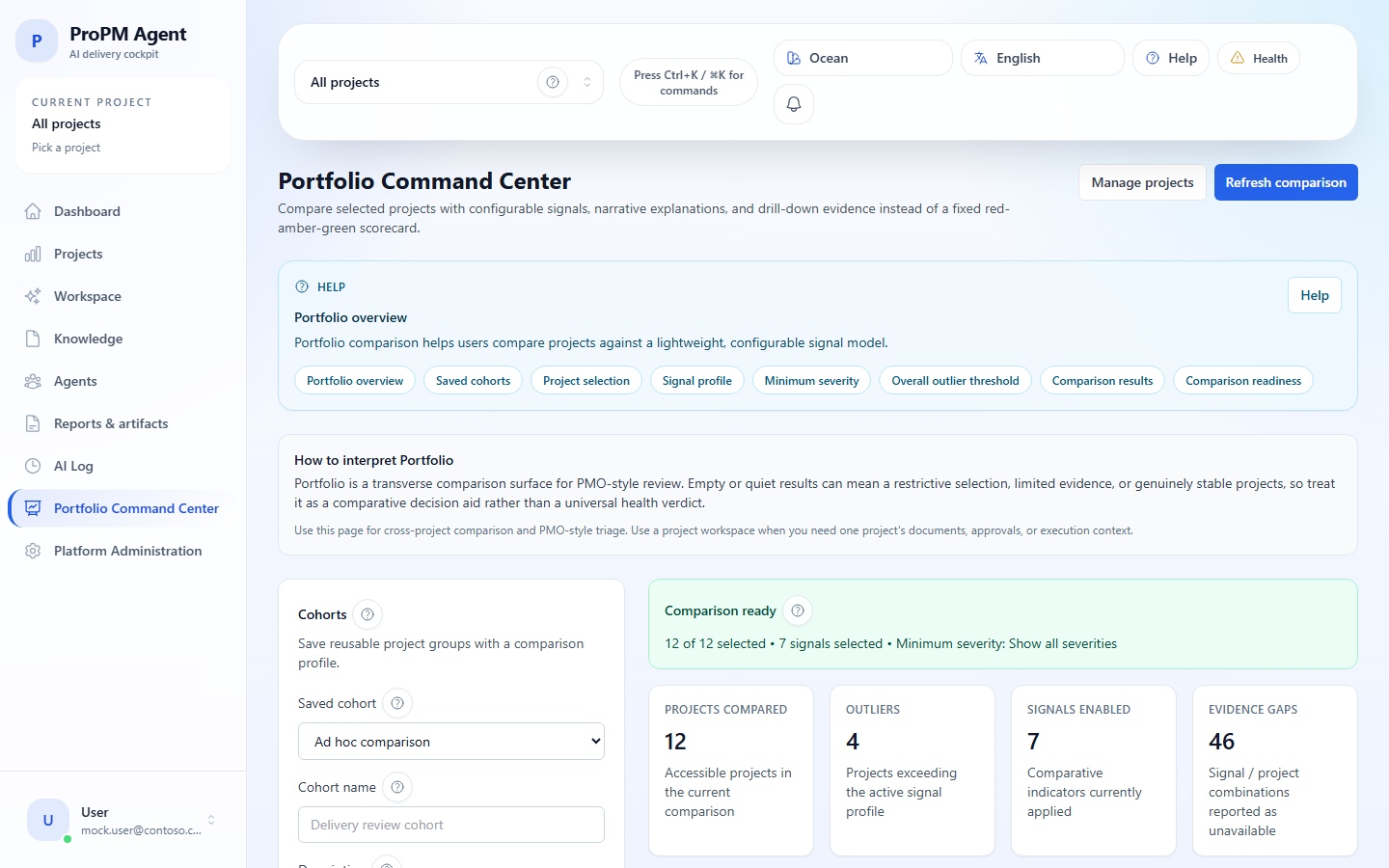

What the user sees when arriving on the page
When arriving on the Portfolio page, the user typically sees five areas.
| Area | What you do there |
|---|---|
| Project selection | choose which projects enter the comparison |
| Signal profile | choose signals, their weights, thresholds and minimum severity |
| Cohorts | save or reload a reusable comparison configuration |
| Comparison results | read the summary, outliers and differences between projects |
| Project drill‑down | open proofs, recent activity and signal details for a project |
Key terms to understand before starting
| Term | Simple explanation |
|---|---|
| Project | a project included in the comparison |
| Signal | a comparative indicator, e.g., blockages, freshness or schedule pressure |
| Weight | the importance given to a signal in the overall score |
| Threshold | the level at which a signal starts to stand out as notable |
| Minimum severity | a filter that hides weak signals |
| Cohort | a group of projects saved with its comparison profile |
| Outlier / anomalous value | a project that stands out more than others according to the active configuration |
| Narrative comparison | a textual summary of the ongoing comparison |
| Project drill‑down | project‑by‑project detail with proofs and activity |
Guided example — comparing three projects for a weekly review
Suppose a PMO wants to compare three projects:
- Project A;
- Project B;
- Project C.
The goal is to quickly spot the one that needs priority attention before the weekly committee.
Step 1 — Choose the projects
In the Projects area, check the projects you want to compare.
Good habit
Prefer to compare projects that belong to the same management conversation. For example:
- three projects from the same portfolio;
- three projects from the same committee;
- or three projects from the same direction.
Step 2 — Choose useful signals
In the Signal profile, enable the signals that truly matter for your review.
Example for a weekly review:
- blocker_density;
- freshness_issues;
- failed_runs;
- schedule_pressure.
Step 3 — Set the weights
The weight indicates the importance given to a signal.
- if you give a high weight to blocker_density, projects with many blockages will stand out more;
- if you give a low weight to activity_change, that signal will influence the final ranking less.
Step 4 — Set the thresholds
The threshold indicates from when a signal should really attract attention.
- a low threshold makes the comparison more sensitive;
- a high threshold makes the comparison more selective.
Step 5 — Choose the minimum severity
The minimum severity filters what you want to see in the results.
Example:
- low and above = you see almost everything;
- medium and above = you already filter out weak signals;
- high and above = you focus only on more serious topics.
Step 6 — Set the overall outlier threshold
The Overall outlier threshold determines from what combined level a project must be flagged as an anomalous value.
- lower threshold = more projects stand out;
- higher threshold = only the most marked cases stand out.
Observed starting settings
The page does not start from a blank sheet. The observed default settings are:
| Signal | Default weight | Default threshold |
|---|---|---|
activity_change | 1.0 | 45 |
blocker_density | 1.2 | 35 |
freshness_issues | 1.0 | 35 |
contradiction_count | 1.1 | 35 |
failed_runs | 1.3 | 40 |
schedule_pressure | 1.2 | 40 |
cost_pressure | 1.2 | 40 |
overall_outlier_score | — | 55 |
Useful additions:
- minimum severity starts with the all-level view rather than a restrictive filter;
- Reset defaults restores these starting values;
- these defaults are a safe starting point, not a required model;
- there is no hidden product preset beyond these defaults and your saved cohorts;
- some demo environments may also show a seeded cohort, but that content varies by environment.

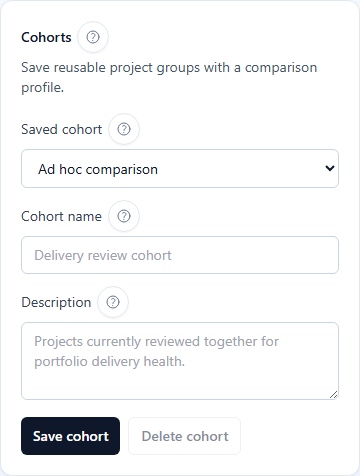

Step 7 — Save a cohort if needed
If you often perform the same comparison, save it as a cohort.
A cohort remembers:
- the chosen projects;
- the activated signals;
- the weights;
- the thresholds;
- the minimum severity.

Step 8 — Run or refresh the comparison
Click Refresh comparison to recalculate the view with the active parameters.
Step 9 — Read the narrative summary
The Narrative comparison area gives a synthesis text.
It generally answers the question:
“What stands out most right now in this group of projects?”
Step 10 — Read the outliers
The Outliers area lists projects that exceed the active weight and threshold profile.
An outlier is not necessarily a “project in trouble.” It simply means:
- it stands out more than others;
- it deserves a closer look;
- you need to understand why it stands out.
Step 11 — Open the project detail
In Project drill‑down, you can view:
- the project’s signals;
- proofs;
- recent activity;
- links to the Workspace, Knowledge, Reports or AI Log.
This step turns a portfolio alert into concrete understanding.
Understanding the signals visible in Portfolio
The signals observed in the product include, among others:
activity_changeblocker_densityfreshness_issuescontradiction_countfailed_runsschedule_pressurecost_pressure
Simple definition of each signal
| Signal | Question it answers | How to interpret it |
|---|---|---|
activity_change | Is recent activity very different from the previous period? | high = unusual variation to explain |
blocker_density | Does the project show many blockages or escalations? | high = frequent or concentrated blockages |
freshness_issues | Are proofs and sources too old or unavailable? | high = the project view becomes less reliable |
contradiction_count | Do sources contradict each other? | high = arbitration or clarification needed |
failed_runs | Do automations or runs fail often? | high = technical or operational friction |
schedule_pressure | Does the schedule show signs of tension? | high = schedule pressure or calendar drift |
cost_pressure | Does the budget or consumption show tension? | high = budget / cost risk |
How to read weights, thresholds and severity with a simple example
Let’s take a very concrete example.
Case 1 — You mainly want to see blocked projects
- increase the weight of
blocker_density; - keep a medium threshold;
- set the minimum severity to
medium.
Expected result: projects with recurring blockages stand out more.
Case 2 — You mainly want to control proof quality
- increase the weight of
freshness_issuesandcontradiction_count; - keep a more sensitive threshold;
- then read the unavailable or contradictory proofs.
Expected result: projects whose reliability becomes low rise faster.
Case 3 — You want a very selective committee
- keep few signals;
- raise the thresholds;
- increase the minimum severity;
- raise the overall outlier threshold.
Expected result: only the most marked cases remain visible.
How to correctly read an outlier
An outlier is not a magic score or a definitive judgment.
In observed flows, a project is an outlier when:
- one or more signals are high;
- those signals carry significant weight;
- the active thresholds are exceeded;
- the combined score exceeds the overall outlier threshold.
Correct reading
- outlier = “this project stands out more than others according to current rules”;
- not outlier = “this project stays within the normal band of the current group”.
Why a signal can be unavailable
A signal can be unavailable when the required proof is missing.
Example:
- if the project lacks proper planning sources,
schedule_pressuremay remain unavailable; - if budget sources are missing,
cost_pressuremay remain unavailable.
Very important point
An unavailable signal does not mean zero risk.
It means:
“The portfolio does not have enough reliable proof to calculate this indicator.”
What a cohort contains
A cohort is a saved comparison profile.
It remembers:
- the cohort name;
- its description;
- the chosen projects;
- the activated signals;
- the weights;
- the thresholds;
- the minimum severity.
Why use a cohort
Use a cohort when you want to repeat the same comparison regularly, e.g.,
- weekly delivery review;
- monthly portfolio tracking;
- risk committee;
- restricted executive review.
When Portfolio looks empty, quiet, or without outliers
Several readings can be normal:
- no accessible project has been loaded;
- no project or no signal is currently selected;
- the comparison returned no usable project summaries;
- some signals are explicitly unavailable because evidence is missing;
- no project exceeds the active overall outlier threshold.
In the project drill-down you may also see, separately:
- no recent activity;
- no visible evidence;
- no remaining signals after the active severity filter.
A quiet result can therefore mean restrictive selection, limited evidence, or genuinely stable projects.
How to read the Project drill‑down area
The Project drill‑down area explains the result.
It can display:
- the project’s weighted score;
- the list of visible signals;
- proofs or documentary excerpts;
- recent activity;
- links to Workspace, Knowledge, Agents, Reports & artifacts and AI Log.
Practical reading
- if a project stands out, start with the narrative summary;
- then open the relevant signal;
- reread the proofs;
- finally check the recent activity to see if the situation is still active.
How the comparison is calculated in the observed application
The portfolio view is not just a static local browser calculation.
Observed behavior:
- the page loads accessible projects;
- it preselects an initial usable set when no project has been chosen yet;
- once the project and signal configuration is valid, the comparison is requested from a service;
- Refresh comparison triggers an asynchronous recalculation and updates the visible snapshot;
- the snapshot timestamp in the narrative summary tells you when that portfolio view was recalculated.
Saved cohorts persist a reusable comparison profile, but they do not replace the live comparison request itself.
Good use of the Portfolio page
Use the Portfolio page to:
- compare;
- prioritize;
- spot gaps;
- decide which project to examine in detail.
Do not use the Portfolio page as a complete replacement for the project’s Workspace.
Part 2 — Platform Administration

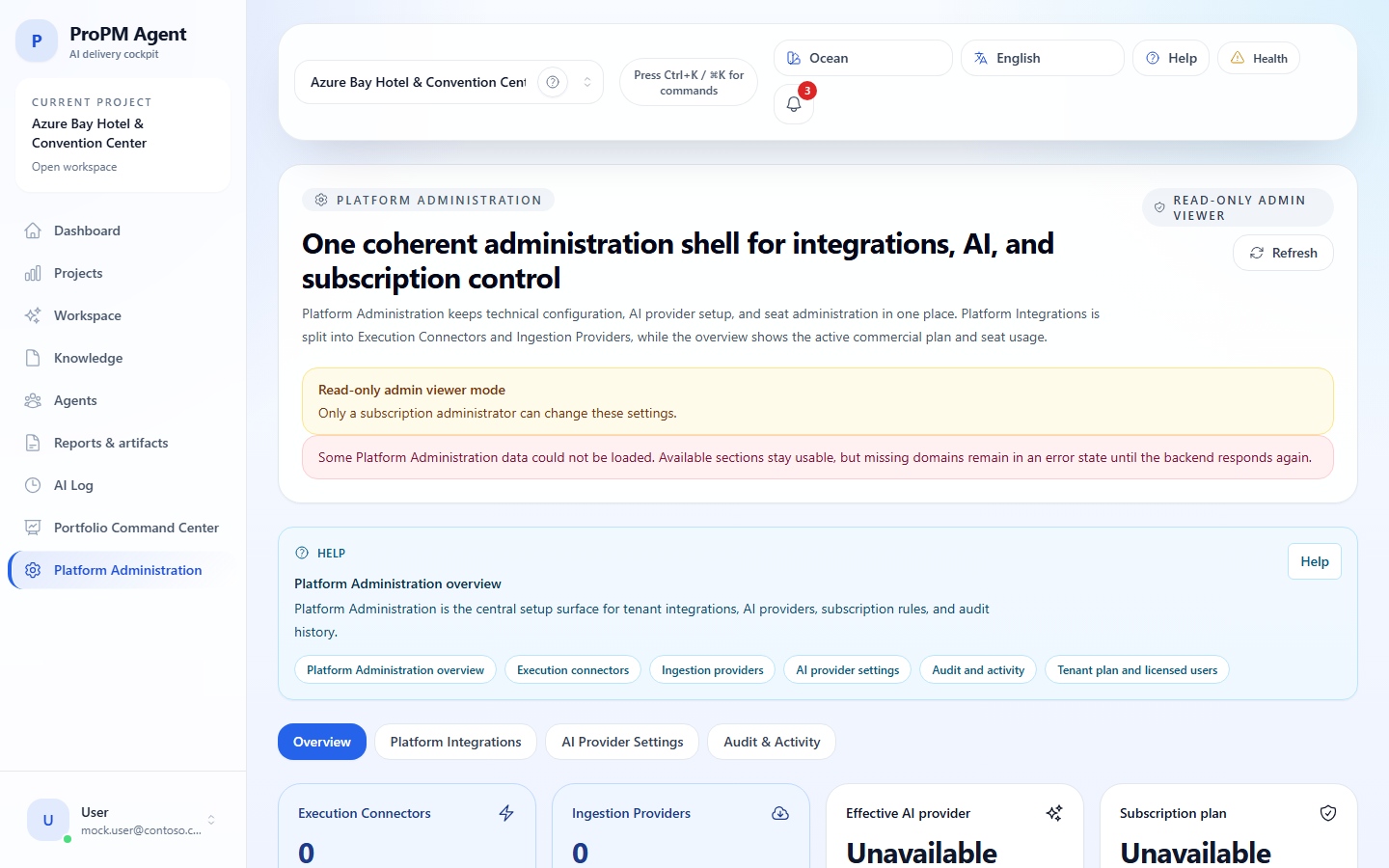

What is this part for?
Platform Administration prepares the platform at the organizational scale.
Here you configure, in particular:
- the platform integrations;
- the AI providers;
- the subscription and seats;
- the activity audit.

Visible sections
| Section | Role |
|---|---|
| Overview | summary of the overall preparation state |
| Platform integrations | technical definitions of connectors and ingestion providers |
| AI provider settings | configuration, validation, test and activation of the AI provider |
| Marketplace & subscription | plan, entitlements, seats and commercial status |
| Audit / activity | history of administrative actions |
Platform integrations vs project integrations
An important rule emerges from the product:
- the platform level decides what exists technically;
- the project level decides what is actually used in a given project.
Simple reading
- platform = we prepare the tool;
- project = we allow the project to use it;
- governance = we decide who can actually act with the tool.
For full detail by connector family, see Connectors and integrations.
Preparation and blocking causes
An integration can be blocked due to:
- entitlement;
- policy;
- permission;
- health to check;
- missing platform definition;
- project binding not opened.
Recommended verification circuit
- reread the project‑side block;
- open Platform Administration;
- verify the technical definition of the connector or provider;
- return to the project to confirm the binding and authorized use.
AI provider settings
The provider families visible in the product include, among others:
- OpenRouter;
- OpenAI-compatible;
- OpenAI;
- Azure OpenAI;
When to choose each provider
| Provider | When to choose | What usually needs to be completed |
|---|---|---|
| OpenRouter | when you need to compare multiple model families via a single connection | Base URL, key, default model |
| OpenAI-compatible | when the client uses a gateway or a compatible endpoint | exact endpoint, auth, key or secret, expected model |
| OpenAI | when the client uses OpenAI directly | URL, key or secret, default model |
| Azure OpenAI | when the client is centered on Azure and wants to choose its Azure OpenAI deployments | endpoint, API version, auth mode, LLM deployment name |
How to read an AI provider’s status
| Status | What it means |
|---|---|
| Configuration | fields are saved |
| Validation | the configuration passed expected checks |
| Test | real connectivity has been verified |
| Operational | the provider can be considered usable |
Very simple step‑by‑step to prepare an AI provider
- open AI provider settings;
- select the desired provider;
- fill in the requested fields;
- click Save;
- click Validate;
- click Test;
- click Activate;
- then check the result in AI Log.
Special case Azure OpenAI
With Azure OpenAI, you often need to complete in the administration:
- the Endpoint;
- the API version;
- the authentication mode;
- the LLM deployment name;
- optionally the Embeddings deployment name.
For details on choosing an AI provider during Marketplace deployment, see Azure Marketplace deployment.
Subscription, entitlement and seats
The product manages a license model with seats and capacities.
What an administrator can see
- the active plan;
- the number of purchased seats;
- the number of available seats;
- users already licensed;
- commercial status, e.g.,
billing state,payment stateorsubscription status.
Why it matters
A blocked user does not necessarily have a connection issue. The block can come from:
- a lack of seats;
- a missing entitlement;
- a feature not included in the plan.
Platform technical landmarks
The observed Azure infrastructure relies on, among others:
- Azure Container Apps;
- Storage;
- Azure AI Search;
- Key Vault;
- Log Analytics;
- Application Insights;
- Document Intelligence.
Takeaways
For the Portfolio page
- start by choosing the right projects;
- enable only the signals useful for your review;
- set weights, thresholds and severity intentionally;
- use outliers as a starting point for investigation, not as a final verdict;
- then open the Project drill‑down to understand the result.
For technical administration
- the platform level prepares connectors and providers;
- the project level opens their real use;
- governance decides who can act;
- an AI provider is ready only when it is registered, validated, tested and activated;
- the AI Log remains the reference to confirm the provider actually used.
